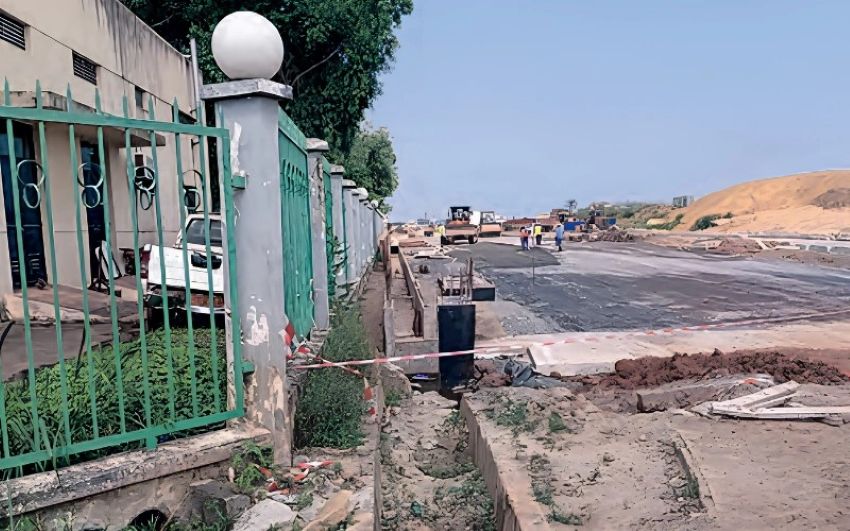

Libreville, Wednesday, August 26, 2026 – The Boulevard de la Transition project in Libreville is now progressing on two distinct fronts. Physically, construction teams are under pressure to accelerate work, overcome delays, and deliver initial sections of the road. Concurrently, within government offices, a far more delicate race has begun: ensuring the meticulous traceability of public funds allocated to this significant infrastructure endeavor.
An investigation, made public on August 23, indicated that a technical and financial review of the contract revealed a substantial increase in its initial value, escalating from 8 billion to 16 billion CFA francs. Furthermore, approximately 3 billion CFA francs were reportedly disbursed to a foreign operator identified as Goran. These allegations, which await confirmation by judicial authorities, have placed this landmark project at the center of serious questions concerning the management of public procurement in Gabon.
The sensitivity surrounding this issue is heightened by the Boulevard de la Transition’s status as a critical urban modernization initiative for Libreville. Spanning approximately three kilometers, the road is designed to alleviate traffic congestion in the capital and forms part of a broader development plan that includes a future administrative city. This project had already been designated a governmental priority for 2026.
Originally envisioned as a symbol of visible urban transformation, the project now grapples with fundamental questions crucial for a state aiming to project a new culture of governance. How could a public contract double in value? What specific procedures facilitated the disbursements that are now reportedly being challenged?
A financial investigation now in the hands of the judiciary
Information obtained from sources within the Taskforce responsible for the control, audit, and verification of state participations and debt suggests that around three billion CFA francs were allegedly paid to the operator Goran without the prerequisite bank guarantee. The individual in question was subsequently reportedly interviewed by the B2 (Gabonese intelligence services) and, according to the same sources, admitted to “serious errors” before departing Gabonese territory. These sources further claim that the entire dossier has since been forwarded to the public prosecutor.
These serious accusations necessitate absolute caution. At this juncture, publicly available information does not definitively establish that an infraction has occurred, much less assign criminal liability to any specific individual. The primary role of the judicial inquiry will be to ascertain the nature of these financial flows, the validity of the contractual procedures, any potential responsibilities, and the circumstances surrounding the operator’s departure.
However, fundamental institutional questions persist. If the absence of a prior bank guarantee is indeed confirmed, why was this essential condition not enforced before the disbursement? If the project’s contract value genuinely doubled, what contractual modifications, administrative approvals, and economic justifications account for such a significant escalation?
These inquiries extend beyond the specific case of Goran. They delve into the very functioning of public procurement, a domain where administrative decisions, private enterprises, public financing, and economic interests converge.
The urgency of infrastructure must not eclipse financial accountability
In parallel with the financial investigation, the Taskforce has reportedly intensified its oversight of the construction site. A report dated August 22, which I have reviewed, specifically calls for the rapid procurement of materials, an enhancement of logistical resources, and the resumption of night work. During a meeting on August 20, a presidential directive set a target to bring the section between PK0+240 and PK0+800 to the impregnation phase by September 1.
This accelerated resumption of work aligns with the project’s critical urban importance. Yet, it also raises pertinent governance questions. While the state legitimately seeks to swiftly complete an infrastructure that residents eagerly anticipate, it must equally safeguard evidence, meticulously document contracts, and establish any potential responsibilities when an audit uncovers anomalies.
The paradox of the Boulevard de la Transition lies precisely here: the more visible the construction site becomes, the higher the demand for transparency must be. The public not only wishes to see asphalt laid; they also expect to understand the project’s true cost, the reasons behind that cost, and the specific rules governing contract awards and execution.
This demand for transparency is particularly strong given that the government has previously faced the financial and social repercussions of major urban works. In 2025, the Council of Ministers approved a waste management plan for debris generated by Libreville’s modernization and the Boulevard de la Transition project. Furthermore, the resettlement program for affected populations received support from the BDEAC (Development Bank of Central African States).
Therefore, this dossier must be monitored along two parallel and inseparable tracks. The first concerns the effective delivery of the infrastructure. The second pertains to the financial truth behind the contract. The success of one cannot compensate for the failure of the other.
The Boulevard de la Transition should not become merely a symbol of a construction site measured solely by kilometers of road built. It must also serve as an opportunity to demonstrate that public investment can be rigorously controlled from initial signing to the final franc spent. If the alleged anomalies are confirmed, responsibilities must be established, and any resulting damages rectified. Conversely, if they are not, the judiciary must also clearly state this. In either scenario, the true work of the Transition mirrors the long-standing demand of citizens: to ensure public funds are traceable, justifiable, and verifiable expenditures.
